The $100K Equity Research Framework: Using Claude as Your Management Consultant
The equity research project management system investment firms pay consultants six figures to implement. Built on Claude Cowork. Free.
Every equity research team has a process for analysis.
Almost none of them have a process for memory.
The model gets built. The thesis gets written. The calls get made. But the decisions, why a company got dropped, why the timeline shifted, what the CIO flagged in the last review, those live in someone’s head. Or in a email body nobody can find. Or nowhere at all.
Six weeks into a research project, half the context is gone.
Not because analysts are careless. Because there was never a system to capture it in the first place.
This is the problem Claude Cowork solves, but only if you set it up correctly. Out of the box, Claude has no memory of your project either. Every new session starts blank. You re-explain the coverage universe. You re-brief the thesis. You rebuild what you already built.
The fix is a context system. A set of structured files that Claude reads at the start of every session, updates as decisions get made, and references automatically when something changes.
Four phases. One source of truth. Zero re-explaining.
Here is the full workflow.
The Problem With How Most Teams Use AI
Most finance teams using AI today are getting outputs, not leverage.
Ask a question. Get an answer. Close the tab. Start over tomorrow.
The problem is not the tool. The problem is that every session starts from zero. Claude does not know your coverage universe. It does not know why you dropped that company last week. It does not know what the CIO flagged in the last review. It does not know your thesis shifted.
So you explain it again.
And again next session.
And again the session after that.
You are not building anything. You are running in place with a faster pair of shoes.
The teams getting real leverage are not using Claude to answer questions. They are using it to run projects. Where context compounds. Where a decision made in week two automatically updates the timeline, the risk register, and the stakeholder communications. Where nothing gets lost because everything gets written down in files Claude can actually read.
That is what this workflow builds.
The Four-Phase Workflow
Phase 1 and Phase 2: Building the Foundation
First, the setup.
If you are starting with Claude Projects, create a new Project in Claude and name it after your research report. Upload your initial research notes, any earnings transcripts you already have, and the three skill files from the download bundle at the end of this newsletter.
If you are on Claude Cowork, open the desktop app, click the folder icon, and point it at the project folder on your computer. Claude can now read, create, and edit every file in that folder directly.
Either way, you are ready to start Phase 1.
If you are new to Claude Cowork and want to understand how to select your project folder, navigate the desktop app, and set it up specifically for equity research, read this first: [link to your our previous newsletter]. Come back here once you are set up.
Phase 1: Project Intelligence
This is the most important phase in the entire workflow. Before you plan anything, you teach Claude everything about the project.
Everything that follows- the plan, the risk register, the stakeholder communications is built from one file:

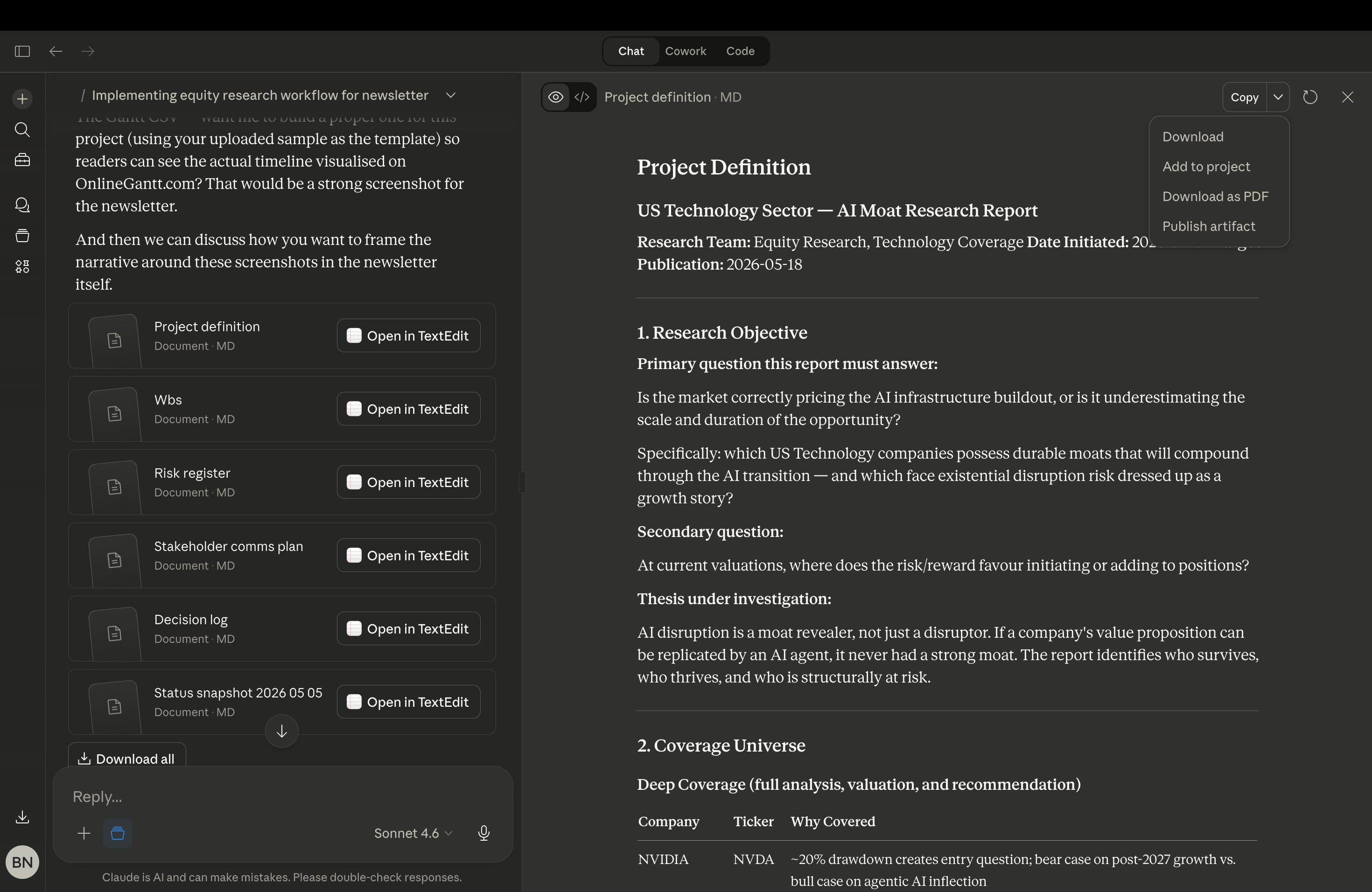

project-definition.mdIf this file is thorough, every session after it gets easier. If you rush it, you rebuild context forever. Run this prompt to start the discovery session:
You are an expert project manager conducting comprehensive discovery for an equity research project. Ask me one question at a time. After each response, summarise what you have learned before moving on.
Cover these areas in order:
1. Research objectives — what question must the final report answer?
2. Coverage universe — which companies are covered and why?
3. Stakeholders — who needs this, what does each person need from it, and how do they prefer to receive updates?
4. Deadline structure — milestones from data gathering through to publication.
5. Known risks and data gaps.
6. Historical context from any previous coverage of this sector.
When we are done, save everything as project-definition.md.Claude will ask you one question at a time. Answer each one specifically. The more detail you give here, the sharper every output that follows will be.
The session takes 30 to 45 minutes if you know your project well.
When it is done, run the premortem prompt immediately, before you move to planning:
Conduct a premortem on this research project. Imagine it is six months from now and the report failed — missed deadlines, wrong thesis, stakeholder alignment broke down. Based on everything you know about this project, what are the most likely failure modes? Rank them by likelihood and impact. Add these to project-definition.md.Research by psychologist Gary Klein shows that imagining failure before it happens increases your ability to identify real risks by roughly 30 percent. This prompt costs you five minutes. It will save you a week.

Phase 2: Structured Architecture
Now you convert the project-definition.md file into a live project plan.
Four artifacts. Four prompts. Run them in sequence.
A. The Work Breakdown Structure

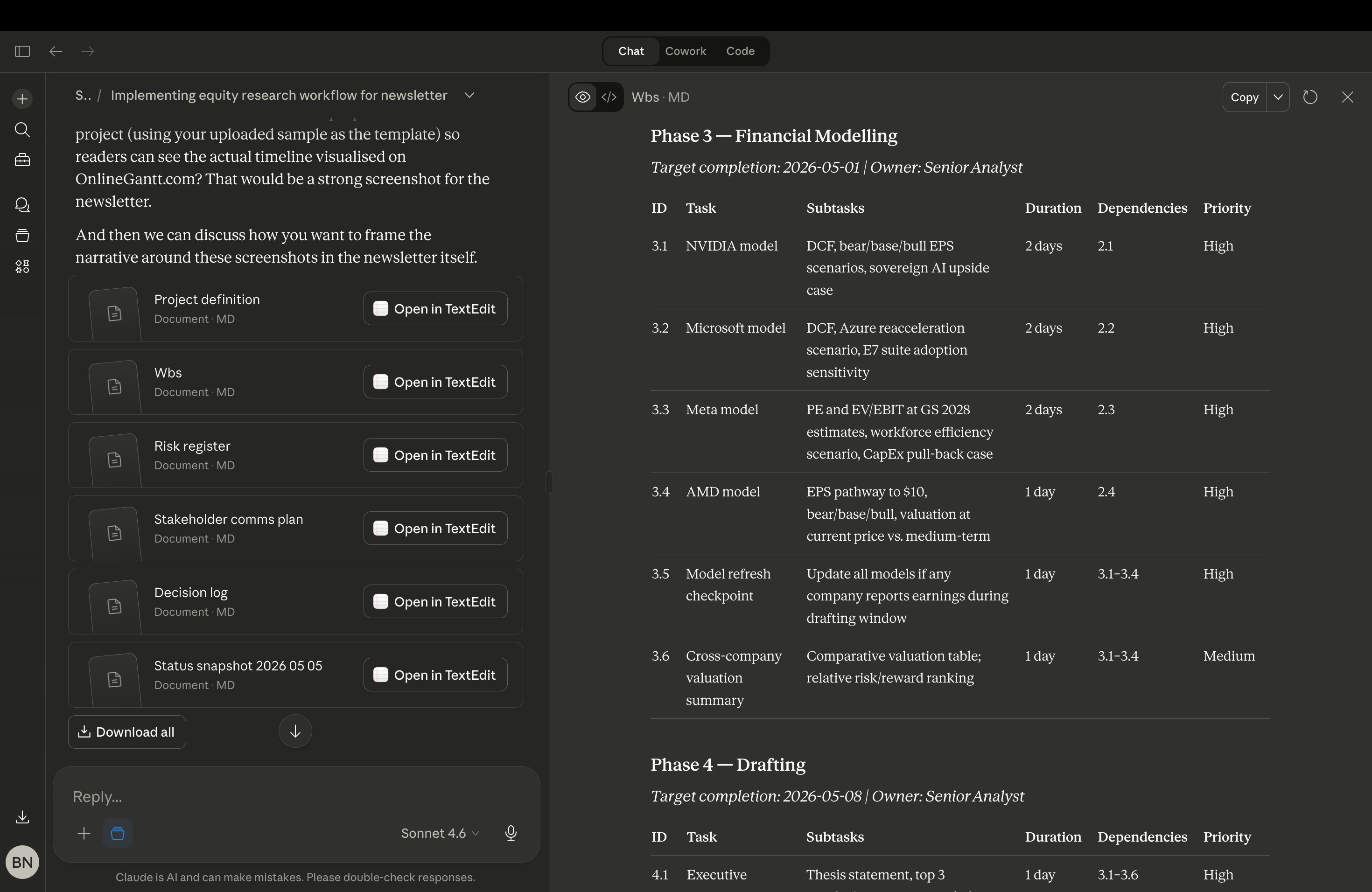

Using project-definition.md, generate a work breakdown structure for this research project. Decompose it into phases (data gathering, analysis, drafting, review, publication), tasks, and subtasks. For each task include: estimated duration, dependencies, responsible party, and priority level. Save as wbs.md.This gives you every task in the project, who owns it, how long it takes, and what it depends on. For a four-company sector report, expect 25 to 35 tasks across five phases.
B. The Risk Register
Convert the premortem risks from project-definition.md into a risk register. For each risk include: description, likelihood (High/Medium/Low), impact (High/Medium/Low), mitigation strategy, owner, and trigger indicators that tell you when to act. Save as risk-register.md.The trigger indicators are the most important column. They tell you exactly what to watch for, so risks don’t surprise you, they get flagged before they land.
C. The Stakeholder Communications Plan

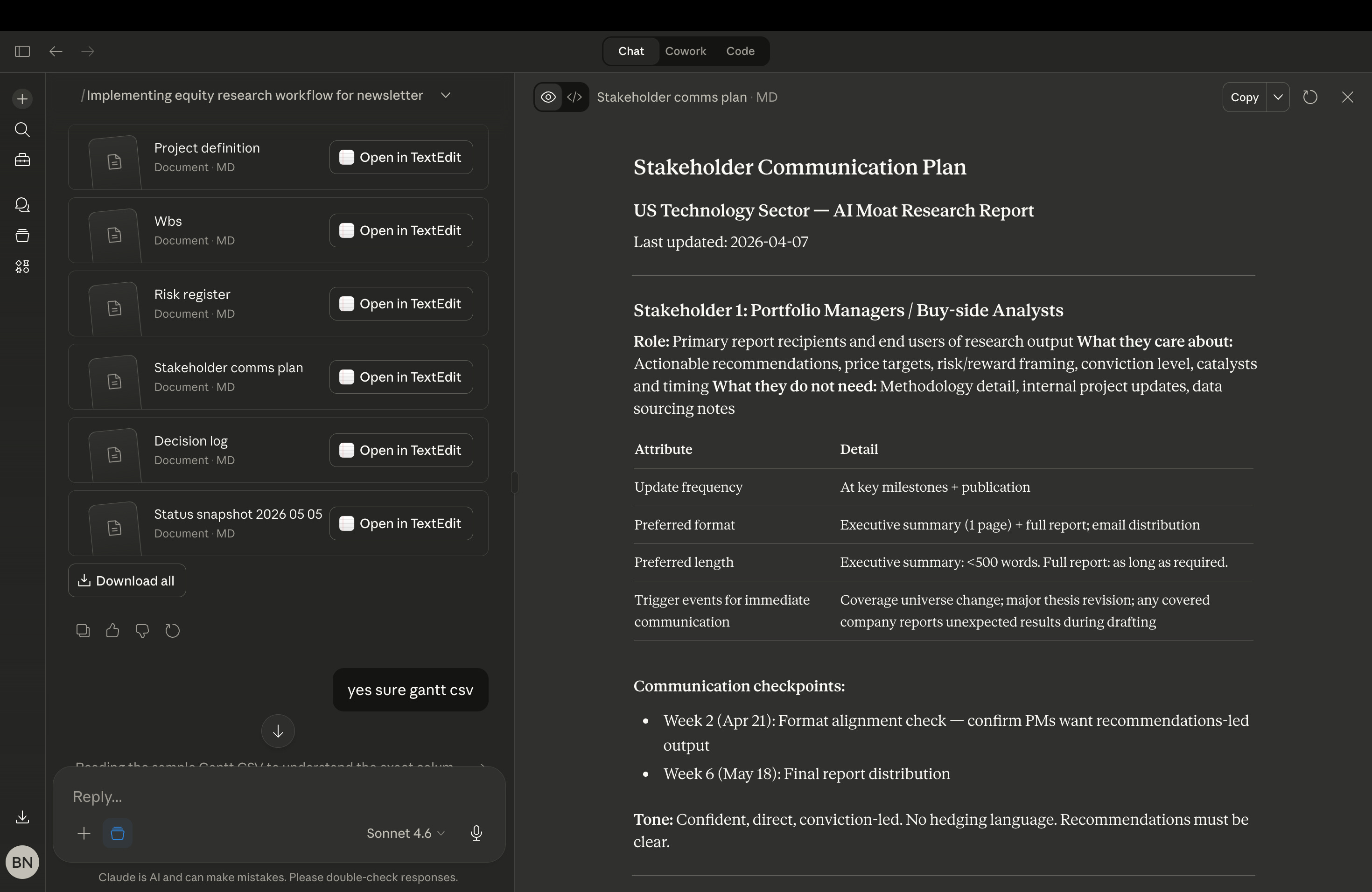

Using the stakeholder information from project-definition.md, create a stakeholder communication plan. For each stakeholder define: their information needs, update frequency, preferred format, and trigger events that warrant immediate communication. Save as stakeholder-comms-plan.md.Every stakeholder gets a different update.
The CIO gets 150 words on milestones and risks. The junior analyst gets a numbered task list. The portfolio manager gets recommendations and risk/reward. One prompt. Three individualised communication plans.
D. The Gantt Chart

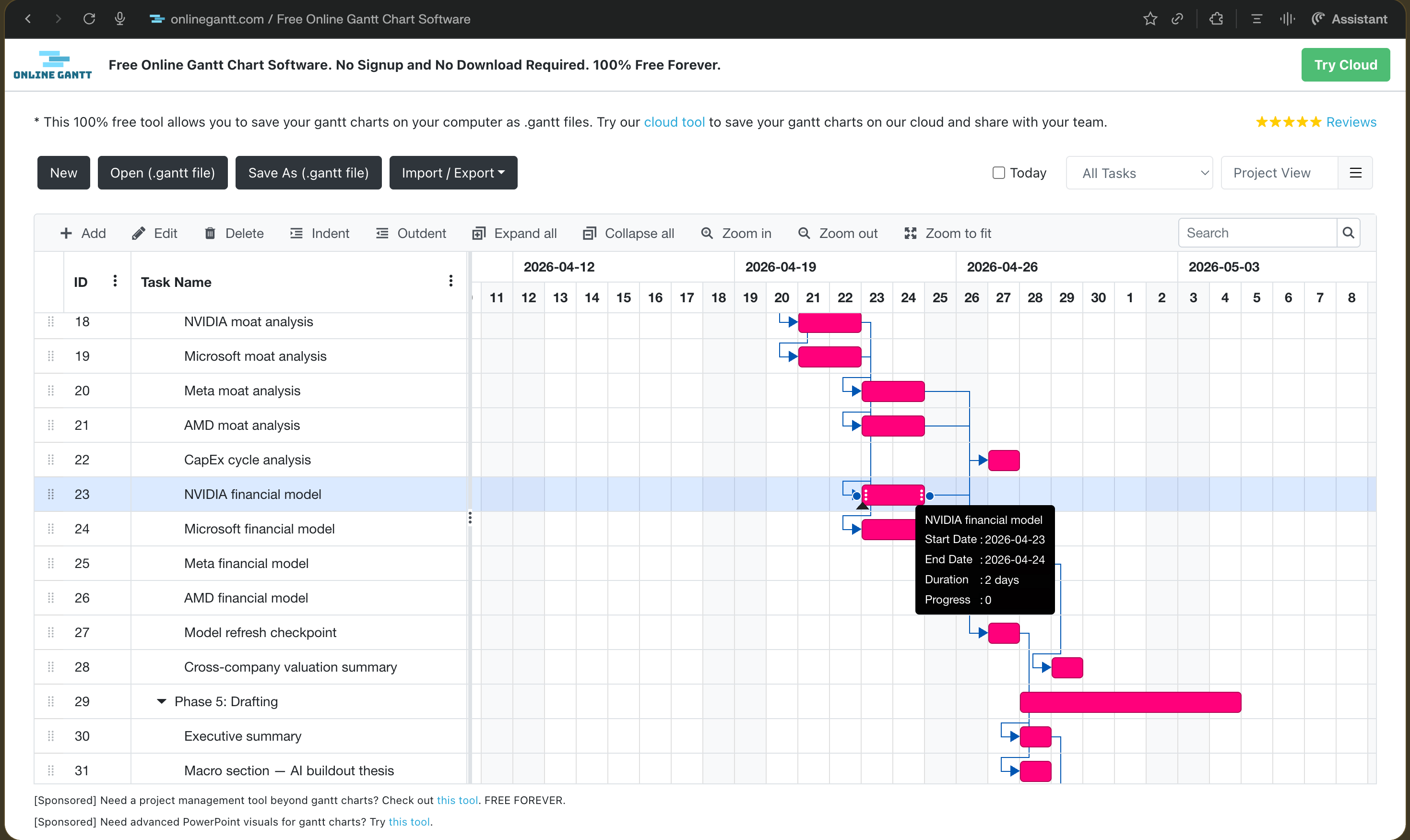

Generate a Gantt chart for this research project as a CSV file. Use this column format: Outline Level, ID, Name, Start, Finish, Duration, % Complete, Predecessors, Resource Names. Save as gantt-export.csv.Once the CSV is saved, upload it to OnlineGantt.com, free, no account required. You get a full colour-coded visual timeline with dependencies in under two minutes.

At the end of Phase 2 your project folder looks like this:
research-project/
├── project-definition.md
├── wbs.md
├── risk-register.md
├── stakeholder-comms-plan.md
├── gantt-export.csv
└── skills/
├── finance-decision-log-skill.md
├── finance-risk-review-skill.md
└── finance-stakeholder-update-skill.mdOne folder. Every file Claude needs to run this project. Always current. Always readable.
The plan is built. Now the project has to survive contact with reality.
Phase 3: When the Project Fights Back
This is where most research projects break down.
Not in the planning. Not in the modelling. In the middle. When something changes and the carefully built plan suddenly has a hole in it.
A company reports earnings during the drafting window. A thesis assumption gets challenged by new data. A coverage decision gets reversed. And suddenly you are manually updating five different documents, re-briefing three different people, and trying to remember what you decided three weeks ago and why.
This is where the context system earns its keep.
Phase 3 is execution. And execution means change. The workflow handles it through three tools- a decision log, a status snapshot, and a risk review, all triggered by single prompts that update the project files automatically.
The Decision Log
Every significant decision gets captured immediately after it is made.
Not batched at end of week. Not summarised from memory. Immediately. Details disappear within 24 hours. A log written on Friday about a decision made on Tuesday is a guess, not a record.

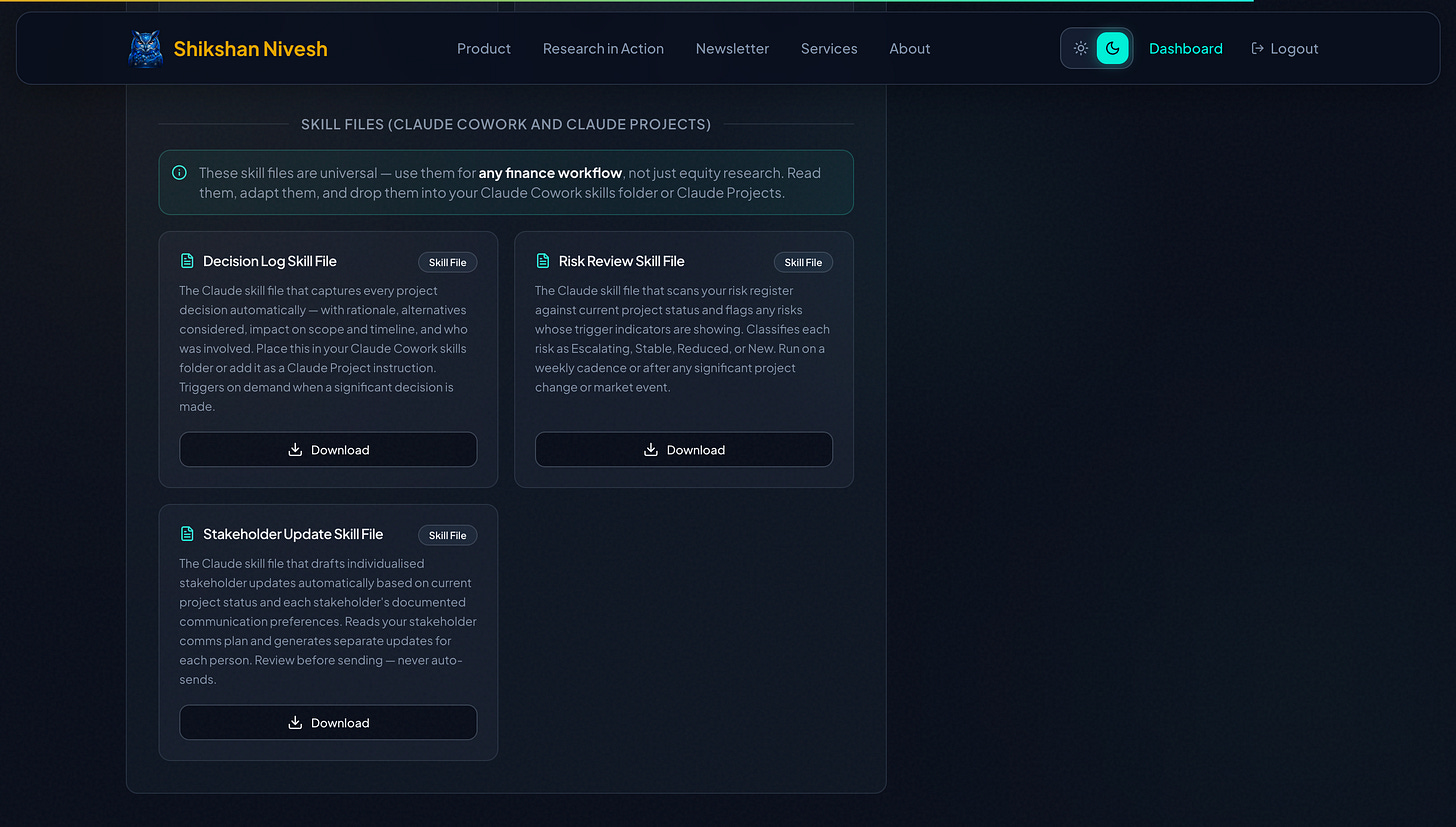

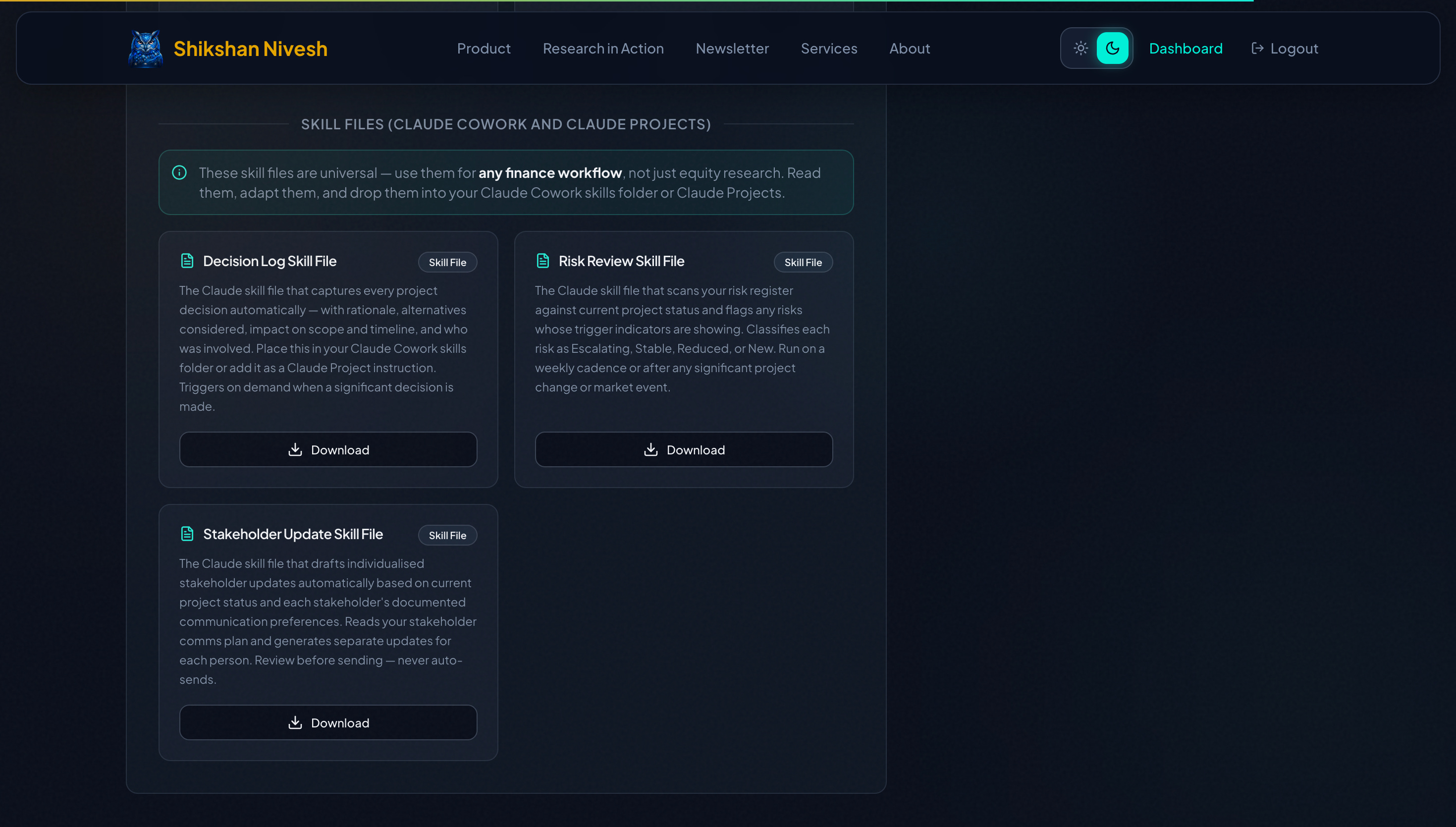

The decision log skill handles this. (download this skill from the download bundle at the end of this newsletter.) If you are on Claude Projects, add the contents of finance-decision-log-skill.md as a Project file. If you are on Claude Cowork, upload the file in a skills subsection inside your customize section, Claude loads it automatically.

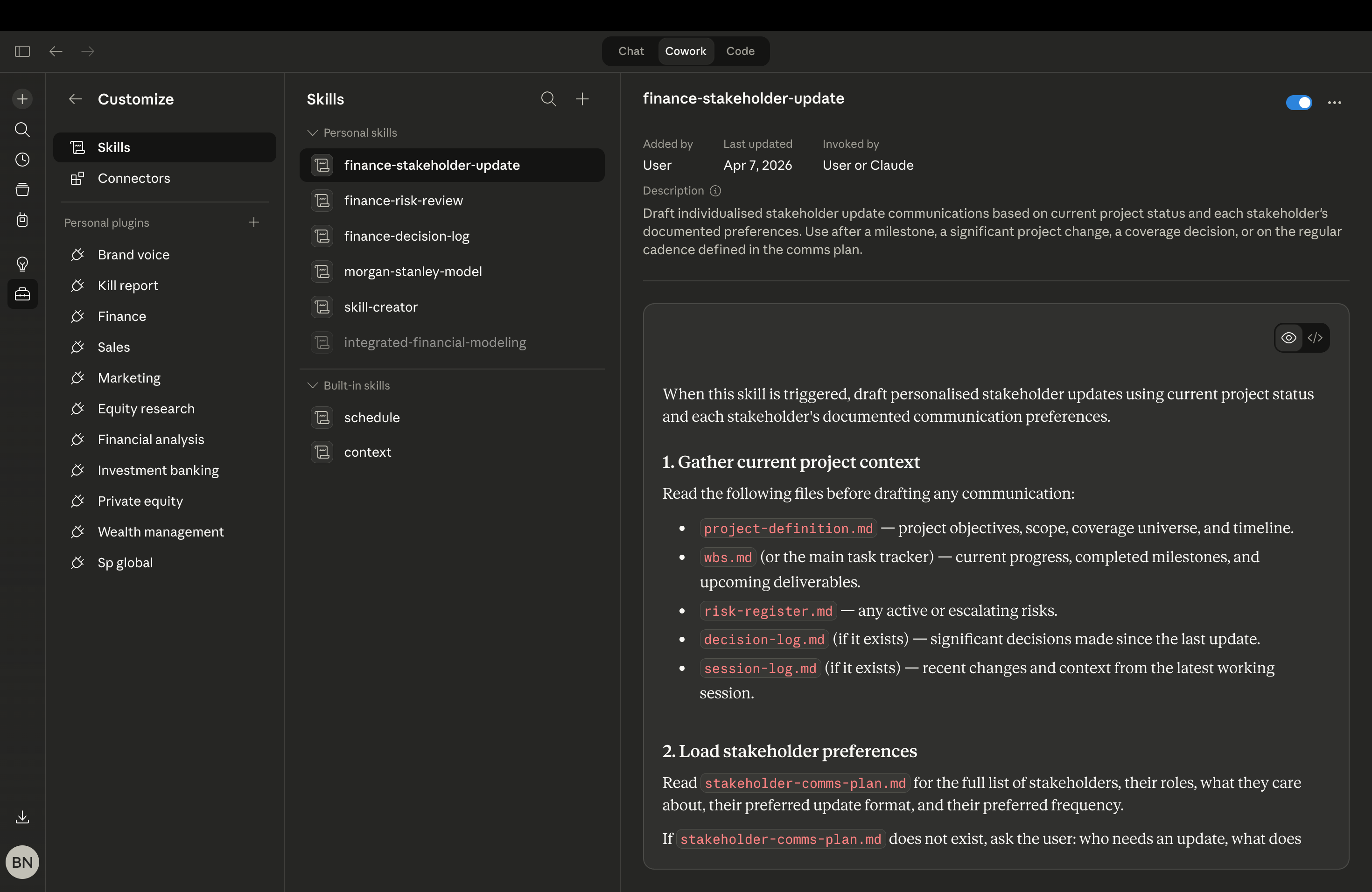

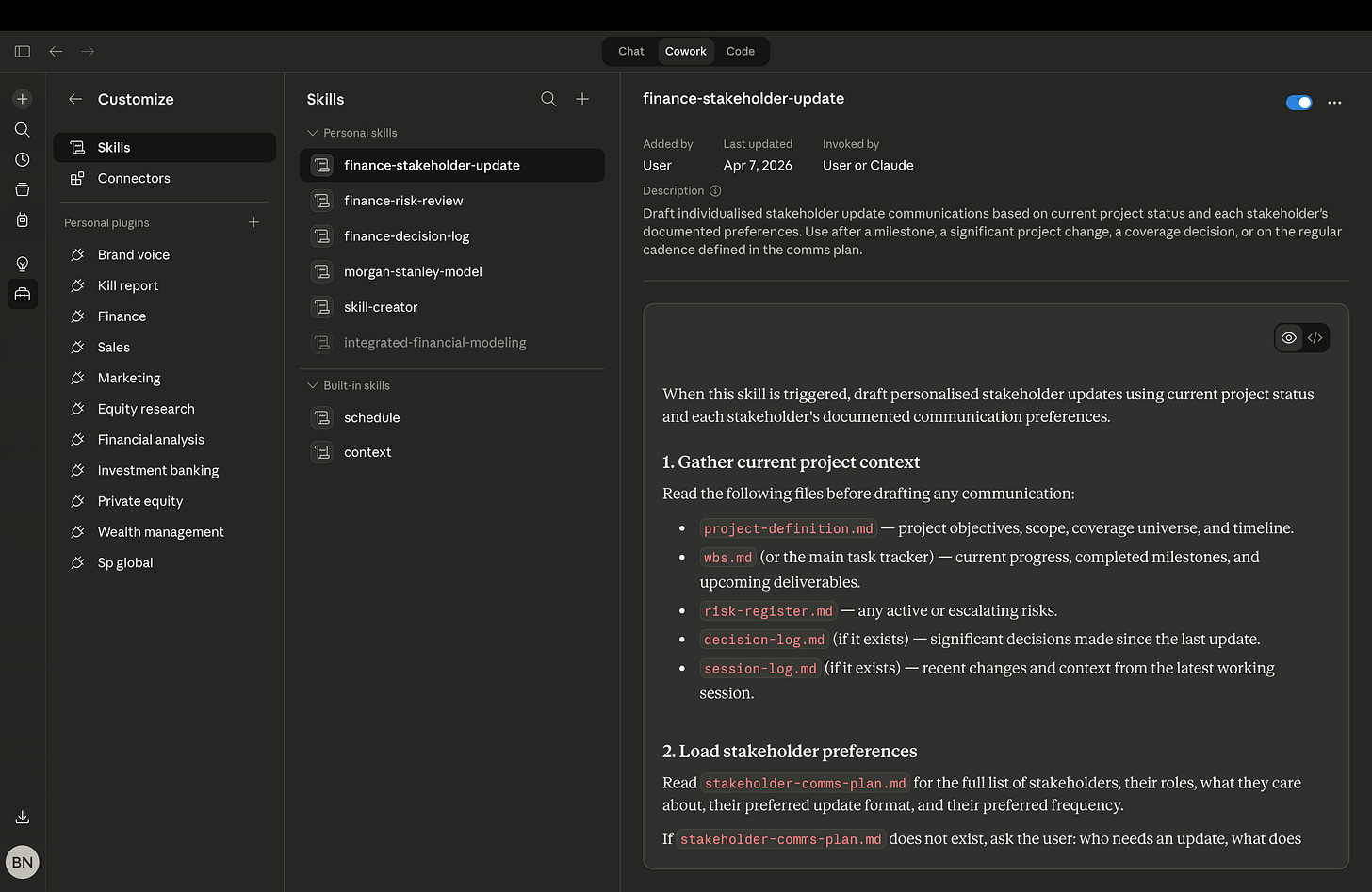

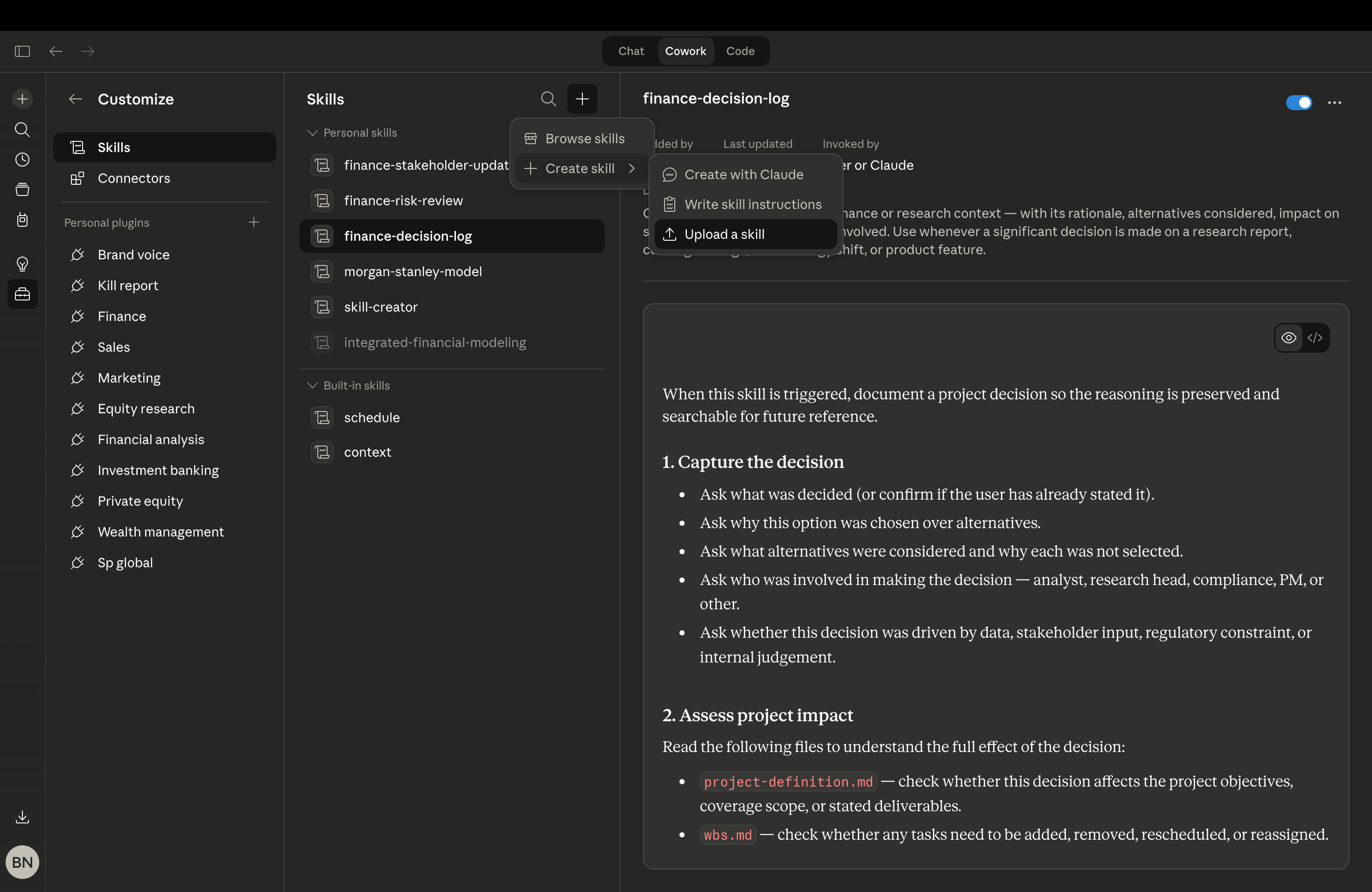

skills subsection inside your customize section, Claude loads it automatically. Then trigger it like this:
Trigger the finance-decision-log skill.
We are dropping [Company X] from the coverage universe. Reason: the most recent earnings call revealed the original thesis no longer holds.
Log this decision, assess the impact on wbs.md and risk-register.md, and draft a brief stakeholder update explaining the change.Claude reads the project files, identifies every task that referenced that company, assesses the impact on the timeline and risk register, and writes the log entry in a format anyone can read six months from now and understand in under 30 seconds.
The following is an illustrative example, built with real companies and real analytical scenarios so you can see exactly what the system produces. The dates and decisions are mock, the workflow and file structure are exactly what you would be running on your own project.

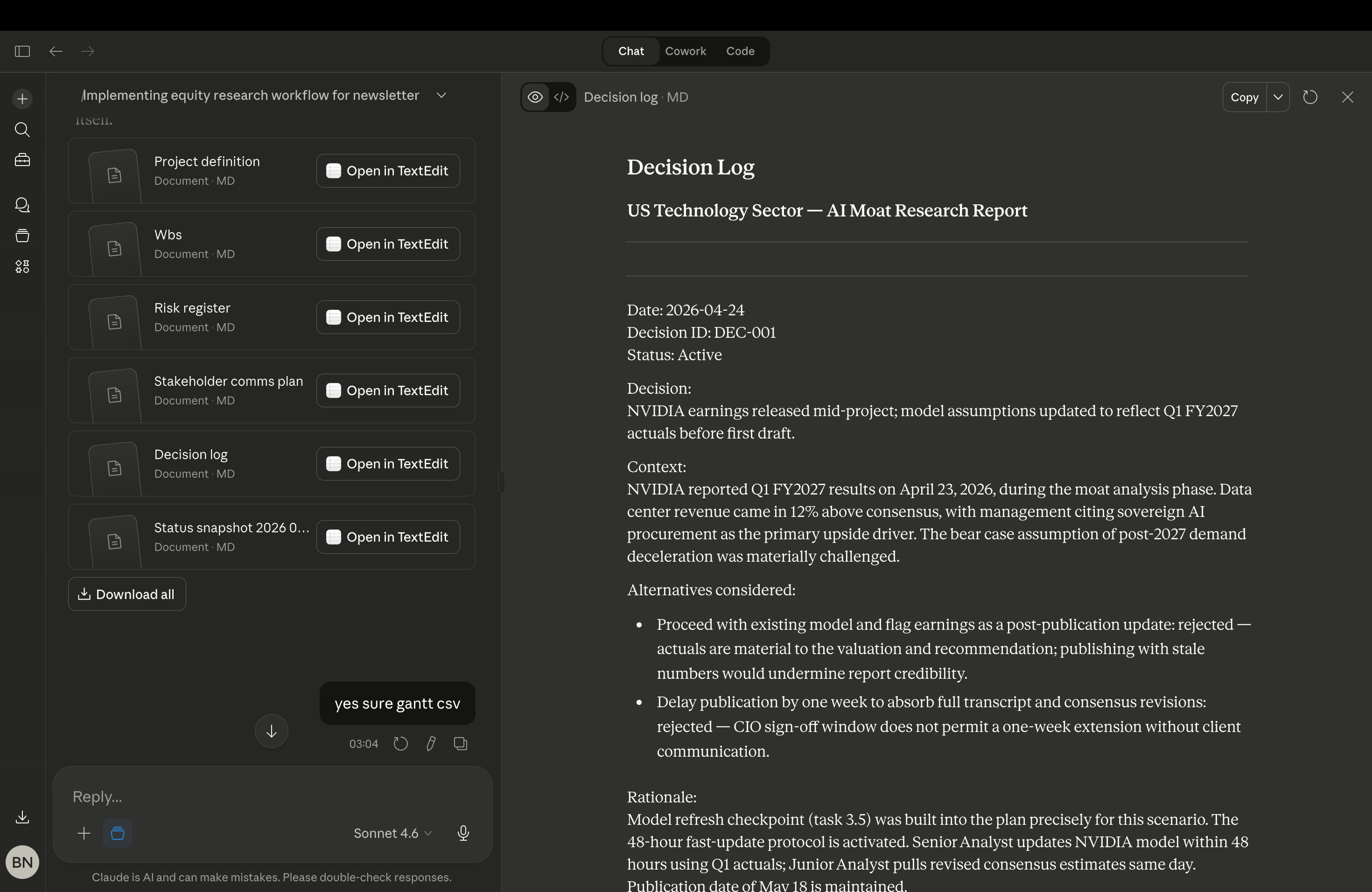

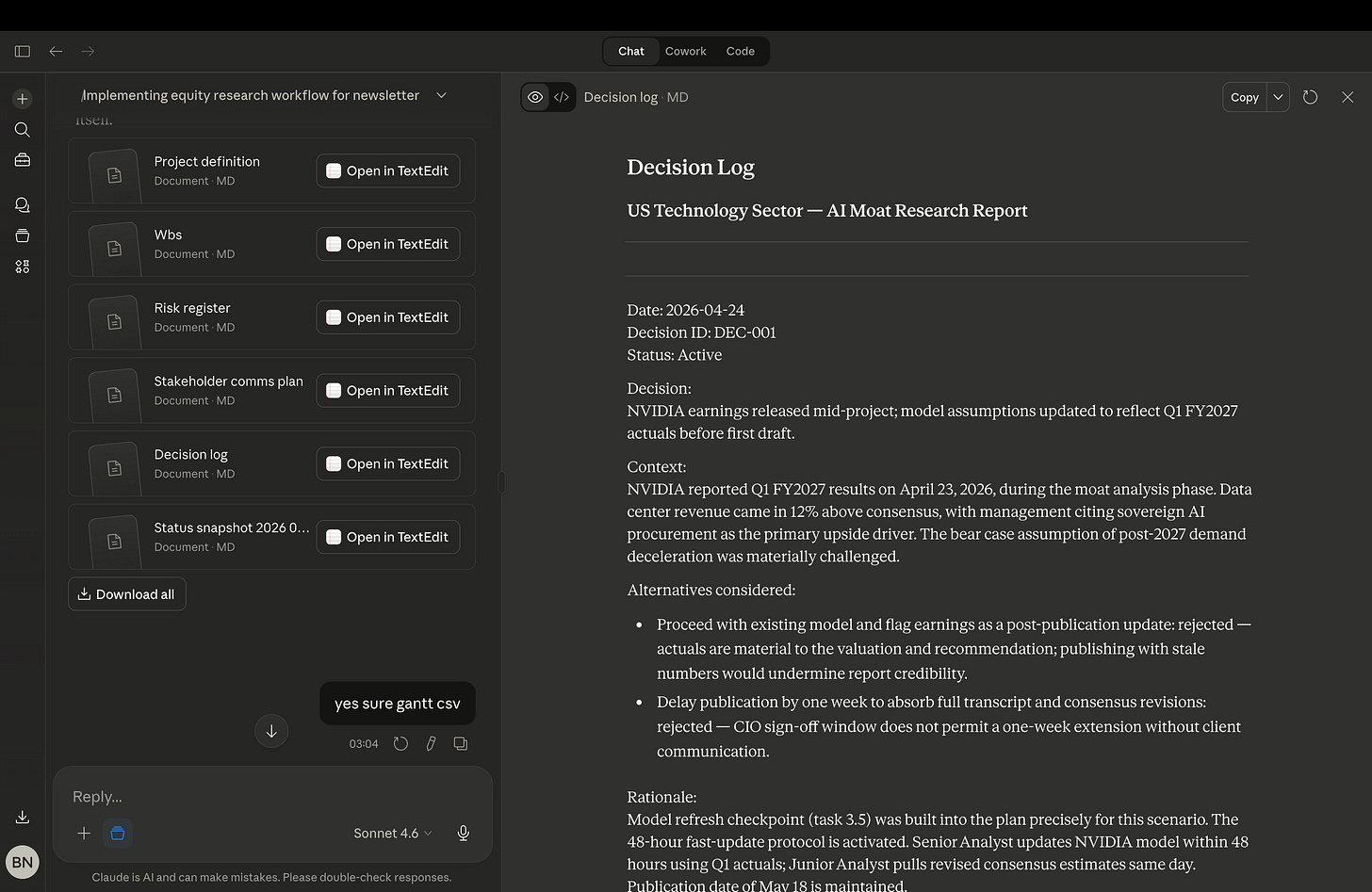

Here is what the entry looks like when NVIDIA reports earnings mid-project and your model assumptions need updating:
---
Date: 2026-04-24
Decision ID: DEC-001
Status: Active
Decision:
NVIDIA earnings released mid-project. Model assumptions updated to reflect
Q1 FY2027 actuals before first draft.
Context:
NVIDIA reported Q1 FY2027 results on April 23, 2026. Data center revenue
came in 12% above consensus. Sovereign AI procurement cited as primary
upside driver. Bear case assumption on post-2027 demand deceleration
materially challenged.
Alternatives considered:
- Proceed with existing model, flag earnings as post-publication update:
rejected — actuals are material to the valuation.
- Delay publication by one week: rejected — CIO sign-off window does not
permit extension without client communication.
Rationale:
Model refresh checkpoint was built into the plan for this scenario.
48-hour fast-update protocol activated. Publication date May 18 maintained.
Impact:
- Task 3.5 (model refresh) activated immediately
- NVIDIA sovereign AI upside case promoted from option to base case
- Risk R-02 moves from Stable to Triggered and Resolved
Decided by: Senior Analyst, Research Head
---Every decision. Every rationale. Every impact. Permanent record.
The Risk Review
Place finance-risk-review-skill.md in the skills folder/section. Trigger it after any significant project change or market event:
Trigger the finance-risk-review skill.
NVIDIA reported earnings yesterday — data center revenue 12% above
consensus, sovereign AI cited as primary driver. Scan the risk register
against current project state and flag anything that needs action today.Claude reads the risk register, cross-references it against the current WBS and any recent decisions, and classifies every risk as Escalating, Stable, Reduced, or New.
Escalating risks get a specific recommended next step. Not a general suggestion. One action, clearly stated.
The Status Snapshot

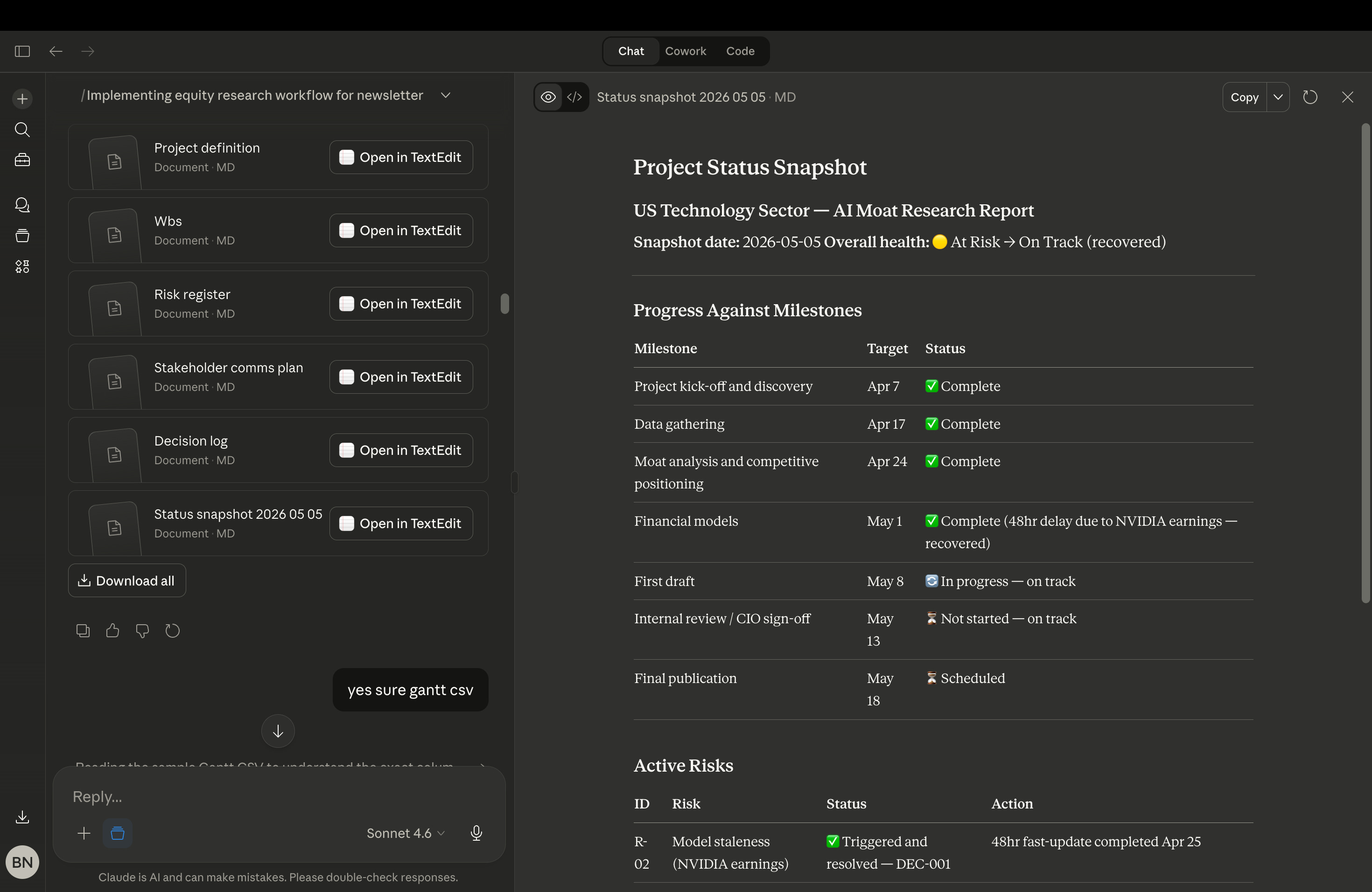

Once a week or after any major change — run this:
Write a project status snapshot as of today. Include: overall health
(Green / Yellow / Red), progress against milestones, active risks,
decisions made this week, and the top priorities for the next seven days.
Save as status-snapshot-YYYY-MM-DD.md.The snapshot becomes your weekly briefing, your CIO update source, and your project memory, all in one file.
Three tools. One principle.
Nothing gets lost. Information compounds. Everything stays connected to the project, the decisions, and the files.
Phase 4: The Automation Stack
This is where Claude Cowork separates itself from every other AI workflow.
Phases 1, 2, and 3 are prompts you run. Phase 4 is tasks that run without you.
Claude Cowork has a scheduling feature. You set a task once, define when it runs, and it executes automatically, reading your project files, generating the output, and saving it for your review. No prompting. No remembering. No manual trigger.
Three scheduled tasks. Add them in this order. Do not add the next one until the previous one is working.
Task 1: The Weekly Briefing
This is the one to start with.
Every Monday at 8am, Claude reads your WBS, your risk register, and any recent status snapshots. It drafts a full weekly report, progress against milestones, active risks, decisions made last week, and top priorities for the coming week. Saved as a file for your review before anyone else sees it.
Set it up with this command in Claude Cowork:

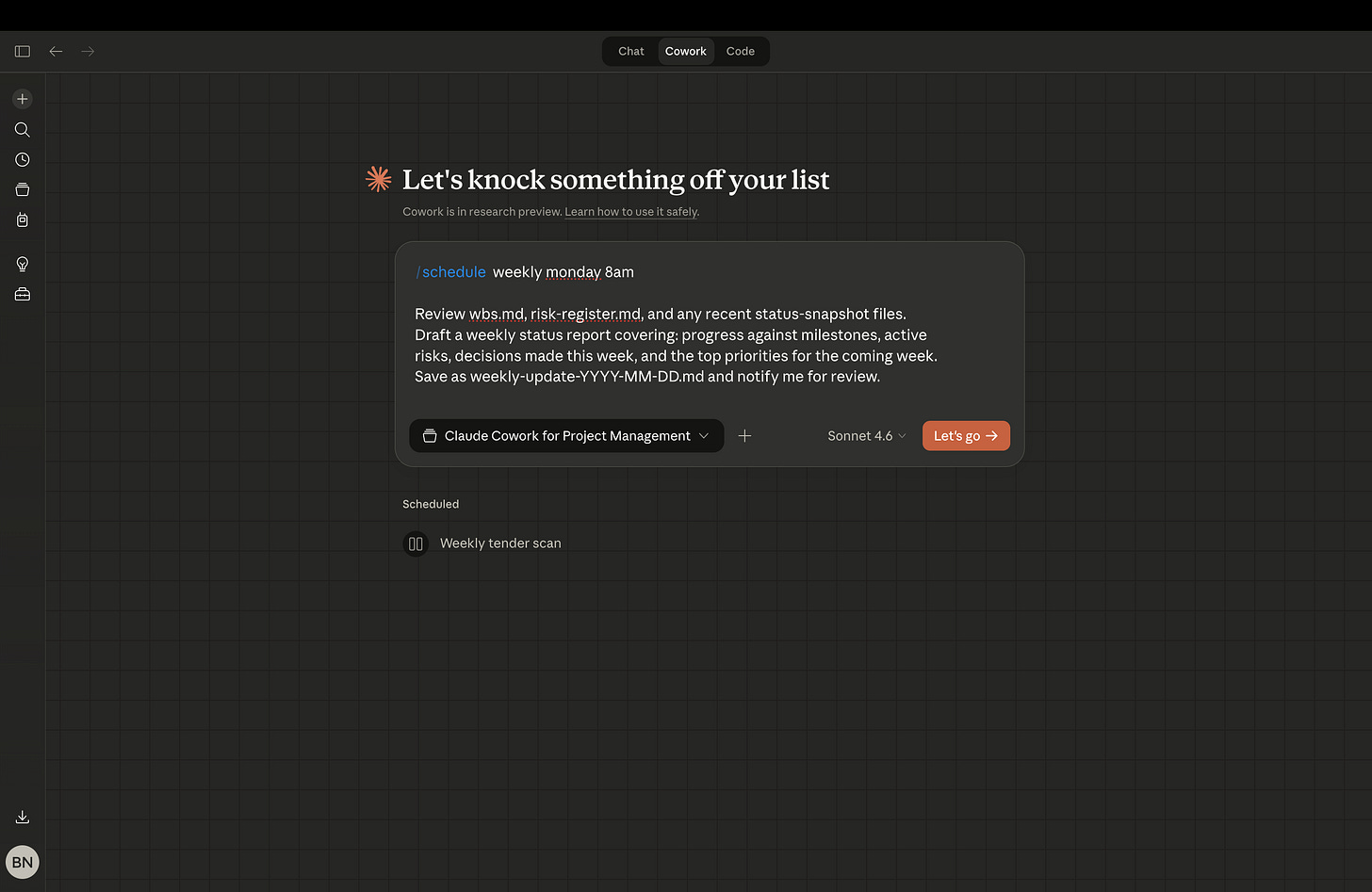

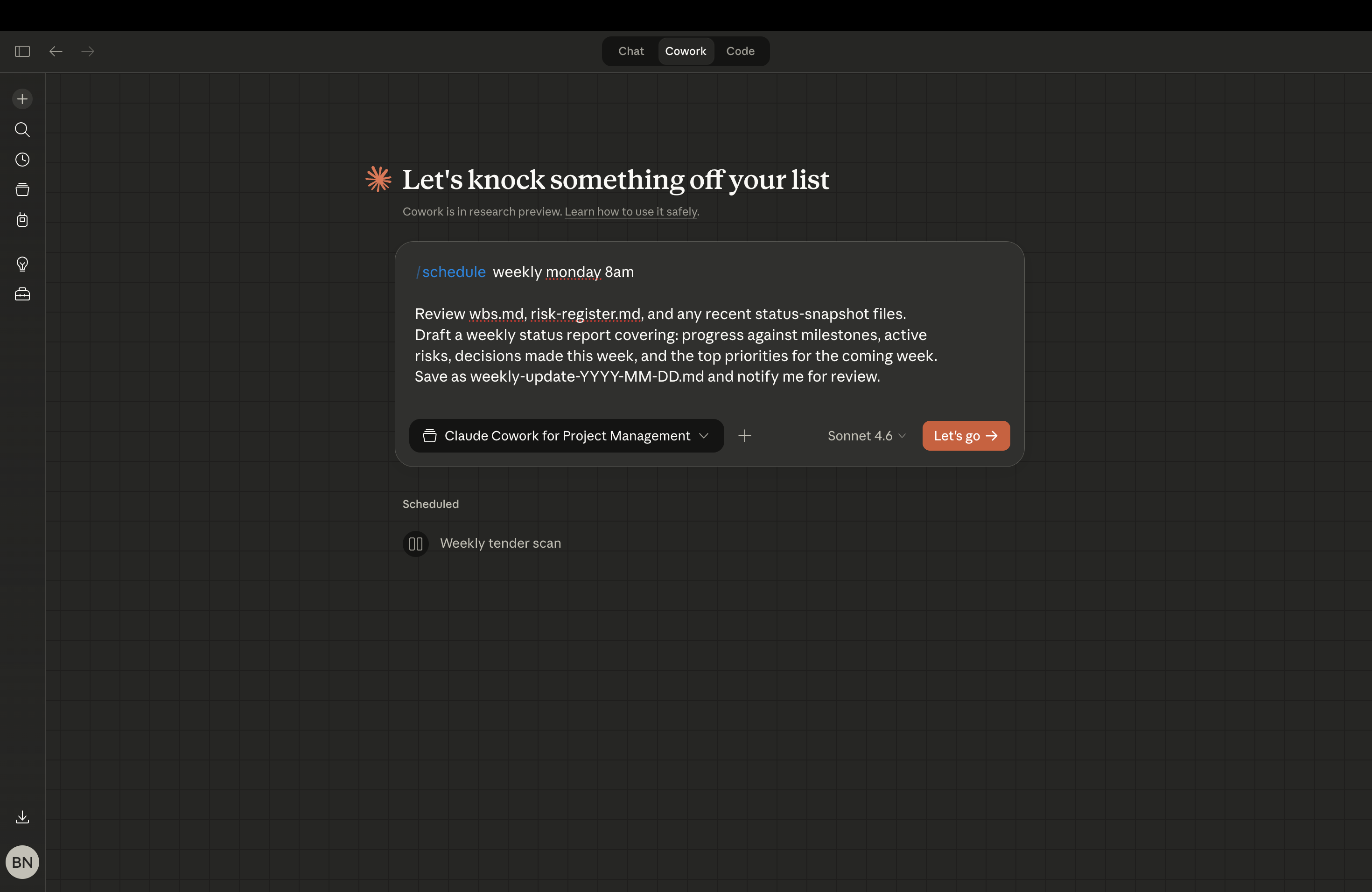

/schedule weekly monday 8am
Review wbs.md, risk-register.md, and any recent status-snapshot files.
Draft a weekly status report covering: progress against milestones, active
risks, decisions made this week, and the top priorities for the coming week.
Save as weekly-update-YYYY-MM-DD.md and notify me for review.Time saved: 45 to 60 minutes every week.

/schedule weekly monday 8am and don’t forget give access to your project folder where all your files live. Give it a context as well that all files live in the project folder.Task 2: The Daily Risk Check
Add this after week one, once you have seen the weekly briefing work at least once.
Every weekday at 9am, Claude scans your risk register for anything rated High likelihood or High impact. It cross-references against current project status. If any trigger indicators are showing, it flags them and suggests immediate actions.
/schedule weekdays 9am
Scan risk-register.md for any risks rated High likelihood or High impact.
Check against current project status in wbs.md. If any trigger indicators
are showing, flag them and suggest immediate actions. Save as
risk-check-YYYY-MM-DD.md.Time saved: 10 to 15 minutes every day.
Task 3: Friday Stakeholder Drafts
Add this after two weeks, once the daily risk check is running cleanly.
Every Friday at 3pm, Claude triggers the stakeholder update skill, reviews all project changes from the week, and drafts individualised updates for every stakeholder, formatted exactly according to the communications plan you built in Phase 2.
/schedule weekly friday 3pm
Trigger the finance-stakeholder-update skill. Review all project changes
from this week. Draft individualised updates for each stakeholder per
stakeholder-comms-plan.md. Present all drafts for review before sending.The Research Head gets 150 words on milestones and risks. The portfolio managers get recommendations and positioning updates. The junior analyst gets a task list for next week. Three different updates. Zero manual drafting.
Time saved: 30 to 40 minutes every week.
Two things to know before you set these up.
Your Mac needs to be awake and Claude Cowork needs to be open for scheduled tasks to run. If the computer is asleep at the scheduled time, the task runs when it wakes. And do not automate anything that goes directly to an external stakeholder until you have reviewed the outputs manually for at least two weeks.
Let the automation handle internal tracking first. Extend it outward once you trust what it produces.
That is the full stack. Four phases. One project folder. A research workflow that remembers everything, updates itself when things change, and runs its own Monday briefing while you sleep.
Get the Full System
The full guide is free.
I put together a detailed resource that walks through this entire workflow, every phase, every prompt, every file, and the complete skill bundle. The project-definition.md discovery prompt, the WBS generator, the risk register, all three skill files, and the Gantt CSV template. Ready to drop into your own project folder and run.
No newsletter summary. The whole thing.
Download it here, sign in required, completely free: https://shikshannivesh.com/research-in-action/the-100k-equity-research-framework
If you want to go deeper, there is a premium membership on shikshannivesh.com. You get access to premium workflows, masterclasses, and free consultancy sessions. Everything we build, you get first.
P.S. Next issue, something new. A Claude Cowork workflow for equity research that most analysts have never thought to automate. No spoilers. Make sure you are subscribed.
🤝 Help Us Grow This Circle
Thank you for reading and supporting Alpha with AI. If you share this edition with even one person who might find it valuable, it means the world to us and helps this project reach those who need it most.
At Shikshan Nivesh, our goal is simple, to make financial research faster, smarter, and more accessible.
We believe investing should start with understanding and every newsletter we write is built to reflect that.
Written by Shubham Borkar | Research & Insights by Shikshan Nivesh AI Team
